Guide to the Microsoft Excel Add-In
Utilize Climatiq’s custom formulas in Microsoft Excel to seamlessly convert your business activity data into carbon estimates.
Overview
The Climatiq Excel Add-In generates audit-ready carbon estimates directly within Microsoft Excel. It uses verified emission factors and data from Climatiq’s trusted Data Explorer to calculate emissions across key business activities such as freight, energy, procurement and more. All estimates are GHG Protocol and ISO 14067 & 83 compliant, with results accompanied by a comprehensive audit trail for transparency.
This makes it easy to calculate, visualize, and analyze carbon emissions in a familiar spreadsheet environment. You can build custom reports, create graphs, and share results with stakeholders.
Pricing & plans
Upon installing the Add-In from Microsoft AppSource, you’ll automatically be enrolled in our free Community plan. This includes 250 emission calculations per month with access to all Climatiq emission calculation formulas. Your monthly allowance resets on the 1st of each month.
Without an active plan, the Add-In provides limited functionality - you’ll only have access to General Estimates and General Search features. If you exhaust your monthly allowance, these basic capabilities remain available until your allowance resets.
Please note that the free plan is only meant for testing purposes. For commercial usage or if you need more than 250 calculations per month, please contact our team . You can also sign up for the Community plan directly here if you haven’t installed the Add-In yet.
Installation guide
Download the Add-In
Install the Add-In from the Microsoft AppSource Store . Once installed, you’ll find it in the “Add-ins” menu in your Excel toolbar. The Add-In is compatible with Excel Desktop versions, or Excel Online. If you already have version 1 installed, make sure to uninstall this before downloading the latest Add-In.

Explore the examples
After installing the add-in, some use-case specific examples will be inserted into your workbook. We have also curated a Templates library in the Add-In sidebar, where you can insert GHG Scope aligned templates for more complex calculations. You can perform calculations directly in your existing business activity files — our templates are there to guide you, but using them is completely optional.
Learn how to calculate in your own file of business data:
Optional: Set your Climatiq Key
Once installed, only if you receive a warning message prompting you to set your Climatiq Key in the Settings tab, please follow these steps.
You can then paste the key in the Climatiq Key box in the Settings tab of the Add-In.

Your Climatiq Key connects the Add-In to your account and tracks your usage against your plan limits.
Keep your Climatiq Key private. Your key is linked directly to your account, and any calculations performed with it count toward your plan limits. We recommend keeping your key confidential or sharing it only with trusted parties.
Navigating the Add-In

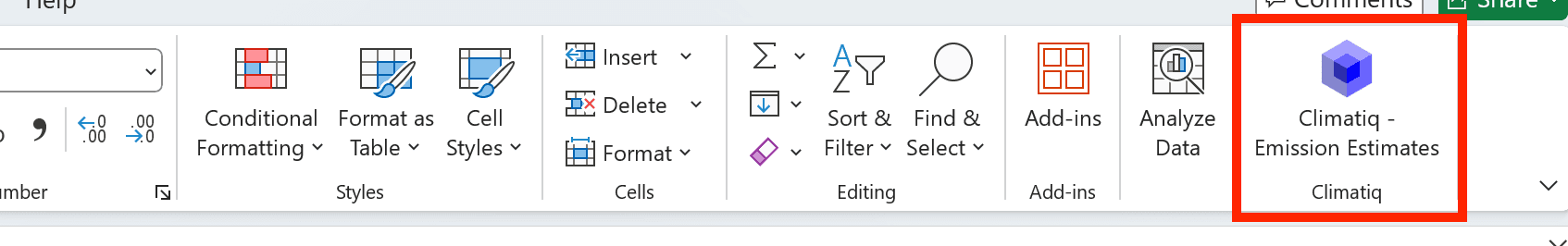

The Climatiq Add-In provides a task pane interface alongside your Excel spreadsheet with five tabs along the top:
- Calculate: The main working area. Choose a calculation type from the formula selector (grouped by category: Search, Mapping Agent, Energy, Travel, Freight, and more). Once selected, the tab shows the formula syntax, required inputs, expected output columns, and a button to insert column headers directly into your sheet. You can also insert formulas directly into your cells from here.
- Batch: Run any supported formula across multiple rows at once, without writing formulas manually. Configure inputs by mapping them to column ranges or fixed values, set an output cell, and run the batch. Results are written to your sheet row by row as they complete, with a live progress bar and per-row error reporting.
- Templates: Access pre-built Excel templates to get started quickly with common calculation patterns.
- Settings: Enter and manage your Climatiq API key, which is required to authenticate all formula calls. Configure which outputs you would like to see, including scope breakdowns, carbon origin breakdowns (fossil, biogenic, neutral, dLUC and total neutral CO2e), and Land and Agriculture (FLAG) emissions.
- Support: Access links to documentation and a built-in feedback form for submitting questions or issues directly to the Climatiq team.
Watch our walkthrough of the Add-In:
Key concepts
Understanding these basics will help you get the most out of the Add-In.

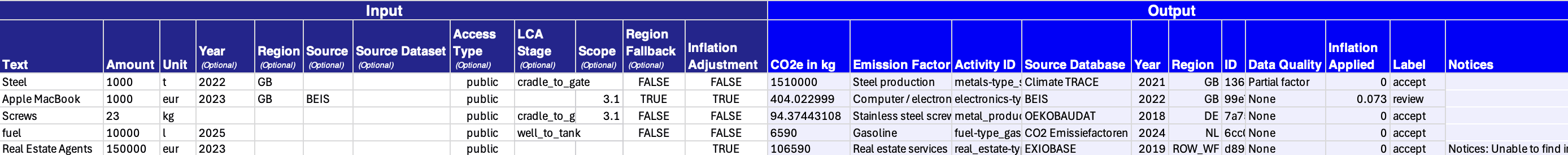

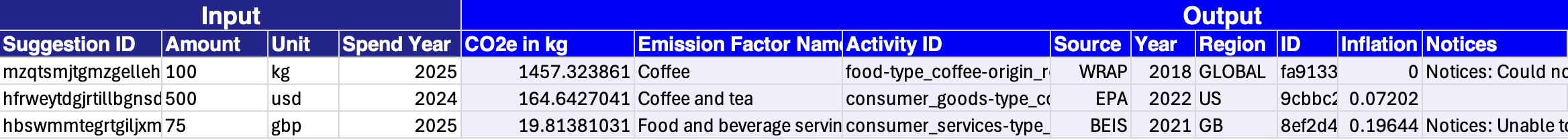

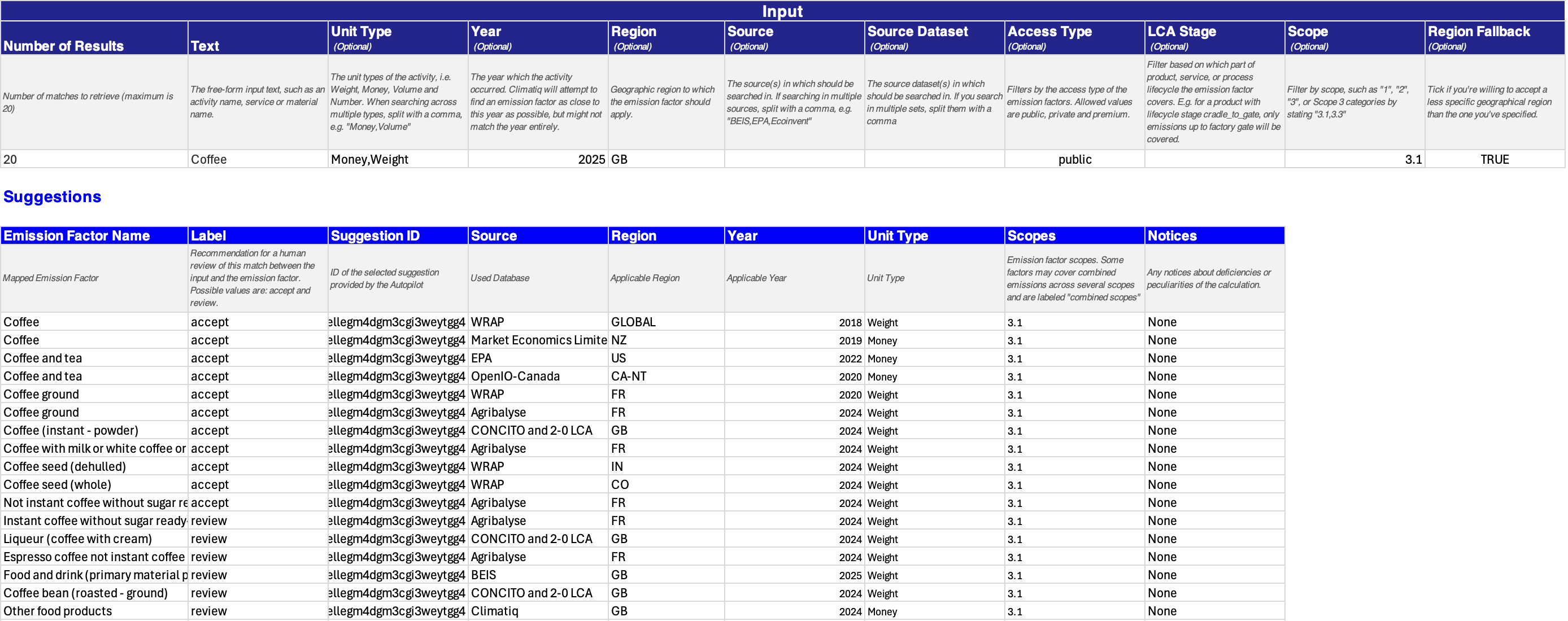

How the Add-In calculates emissions
When you use a Climatiq formula, the Add-In connects to our database of verified emission factors, which are scientific values that convert activities (like flights or energy use) into carbon emissions.
Here’s what happens:
- You provide activity details (like locations, distances, or energy amounts)
- The Add-In shares this data with Climatiq’s API, where the applicable emission estimation methodology is applied and the relevant emission factor for your activity are selected and applied
- Your results are calculated and returned with an audit trail showing exactly which emission factors were used
This ensures your carbon estimates are accurate, transparent, and compliant with reporting standards like the GHG Protocol.
Working with formula inputs
Each formula has required inputs that must be filled in, and optional inputs, shown with square brackets like [flightclass], that can be skipped.
Formatting Rules:
- Text values need quotation marks:
"Berlin"notBerlin - Numbers don’t need quotation marks:
100not"100" - Locations accept city names (“Berlin”), airport codes (“BER”), or coordinates (52.520008, 13.404954)
Example:
Climatiq.Calculate_Travel_Air("BER", "JFK", "economy")✓Climatiq.Calculate_Travel_Air("BER", "JFK")also works ✓ (flight class is optional)
Find valid input values (fuel types, currencies, regions) in the Templates tab of the Add-In.
Understanding results and errors
How Results Are Displayed
Climatiq formulas return results across multiple columns with CO2e emissions, distance/consumption data, applied emission factors, and calculation methodology. To add labels above your results, select the cell directly above your first result and click “Add Header” in the Calculate tab. To add further audit details to the results, utilize our audit-trail formulas.
Common Error Messages
- “Climatiq key not set”: Your Climatiq Key isn’t set correctly. Generate your key and go to the Settings tab to set it.
- “#NAME!”: You forgot quotation marks around text, i.e. change
Berlinto"Berlin". - “You do not have access to this feature”: You’ve reached your monthly limit or this feature isn’t in your plan.
- Other calculation errors: Double-check that your inputs match the required format in the formula documentation.
See the Troubleshooting guide for more help resolving Excel errors.
Configuring your outputs

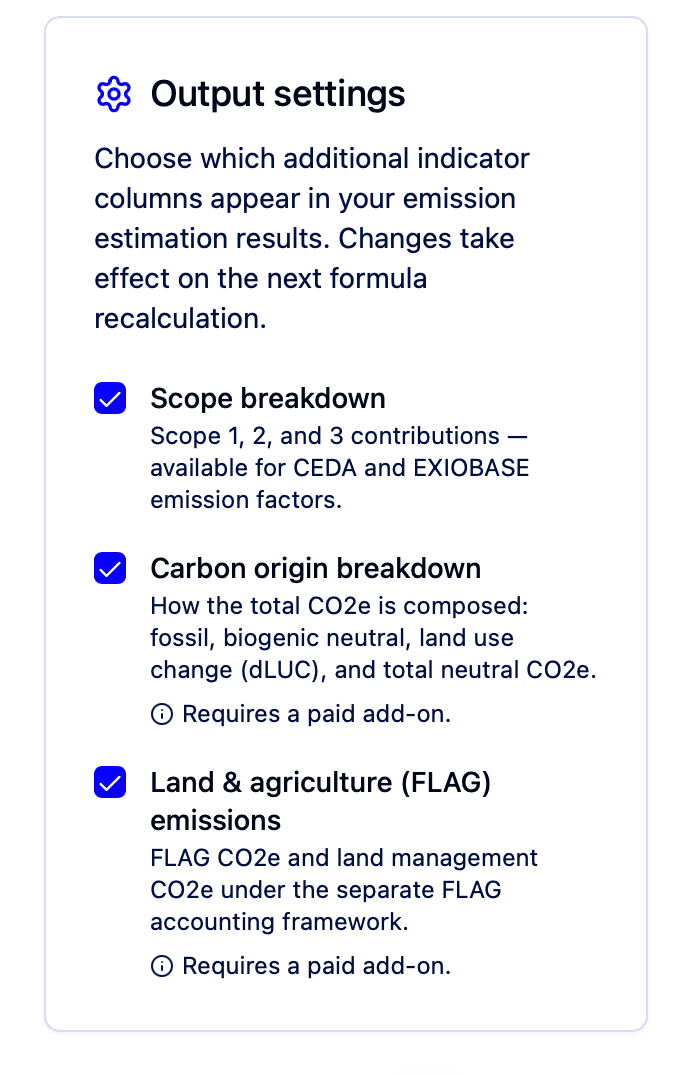

By default, Climatiq formulas return a CO2e total for each activity. In the Settings tab, you can enable additional output columns to get a more detailed breakdown of your results.
| Setting | What it adds | When to use it | Availability |
|---|---|---|---|
| Scope breakdowns | Separate columns for Scope 1, 2, and 3 emissions | GHG Protocol reporting, Scope-level analysis | Available for premium CEDA and EXIOBASE emission factors |
| Carbon origin breakdowns | Columns for fossil, biogenic, neutral, dLUC, and total neutral CO2e | Reporting on biogenic carbon or Nature-based Solutions | Paid add-on required |
| Land and Agriculture (FLAG) emissions | A separate FLAG emissions column | Activities in agriculture, forestry, or land use | Paid add-on required |
These settings apply across all formulas. Enable only the breakdowns you need, as each adds columns to your output range. Changes take effect the next time a formula runs.

Managing your usage
Every time a formula calculates (or recalculates), it counts toward your monthly plan limit of 250. By default, Excel automatically recalculates when you change inputs or reopen files.
To avoid overconsumption, preserve completed calculations as permanent values:
- Select the cells with your calculation results
- Copy them (Ctrl+C or Cmd+C)
- Paste them back as values: Edit > Paste Special > Values
You can also disable automatic recalculation in Excel’s Formulas tab under Calculation Options > Manual.
Batch calculations
The Batch tab lets you run any supported Climatiq formula across hundreds of rows at once, without writing or dragging a single formula. Results are written directly back into your spreadsheet as each row completes.
Batch vs. formulas
Climatiq formulas calculate live in your spreadsheet and update automatically as you change inputs. Batch runs calculations once, writes results as static values, and avoids any recalculation risk.
| Formulas | Batch | |
|---|---|---|
| Best for | Small datasets, testing different input combinations | Bulk estimation across many rows, monthly data runs |
| Results | Live formula values, retrigger on change | Static values written once per run |
| Recalculation on workbook open | Yes (if Excel is set to automatic calculation), which uses your monthly allowance each time | No. Results are written as values and never recalculate |
| Re-triggering | Required if inputs change or results are lost | Not needed; re-run Batch intentionally when your data changes |
| Scale | Practical for tens of rows | Designed for hundreds of rows |
| Monthly allowance usage | Counts each time a formula retriggers | Counts once per row, per run |
Supported formula types
- Mapping Agent: One-Shot
- Energy: Electricity, Fuel Combustion, Heat & Steam
- Travel: Air Travel, Road Travel, Rail Travel
- Freight: Intermodal Freight
- Other: General Estimate
Step-by-step walkthrough
Select formula type

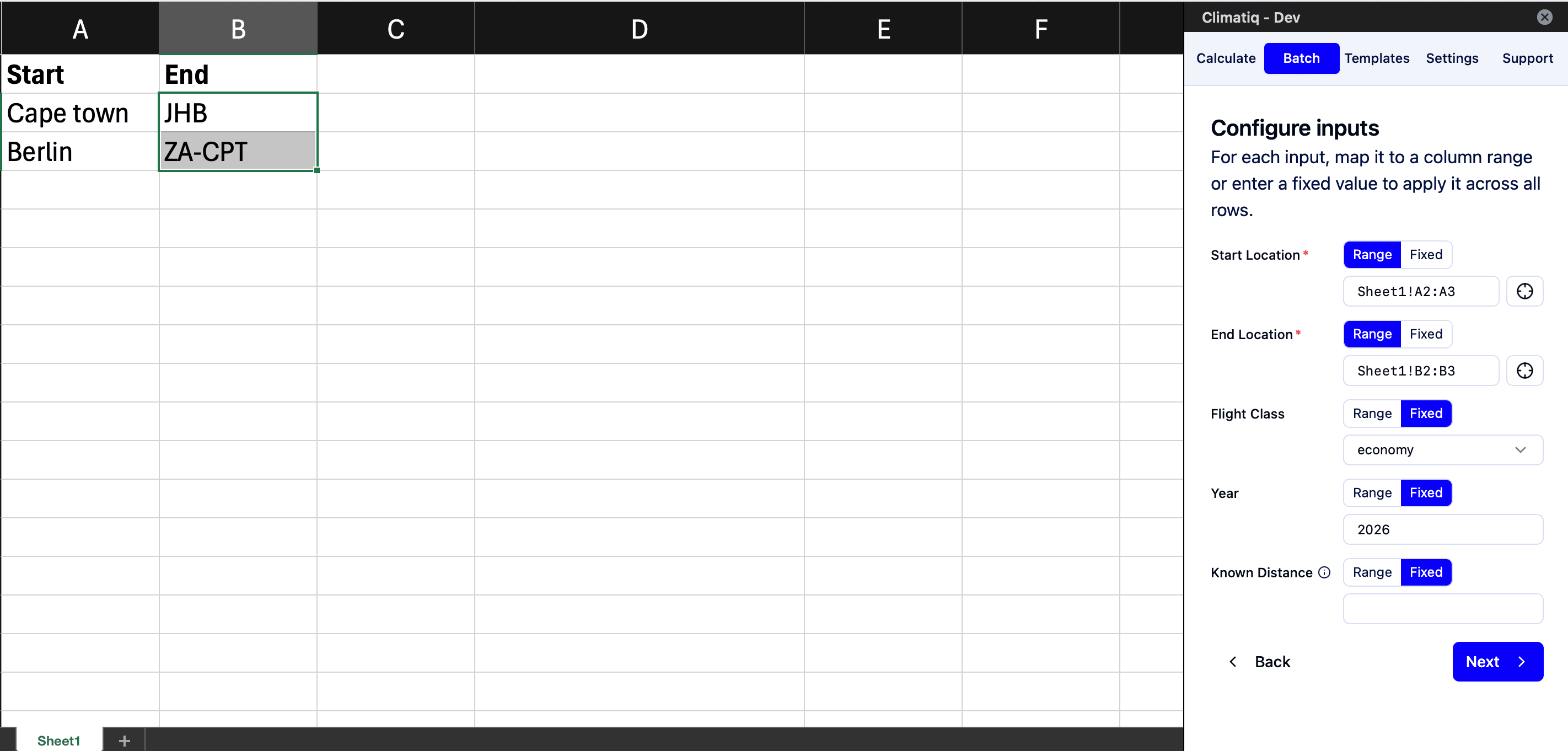

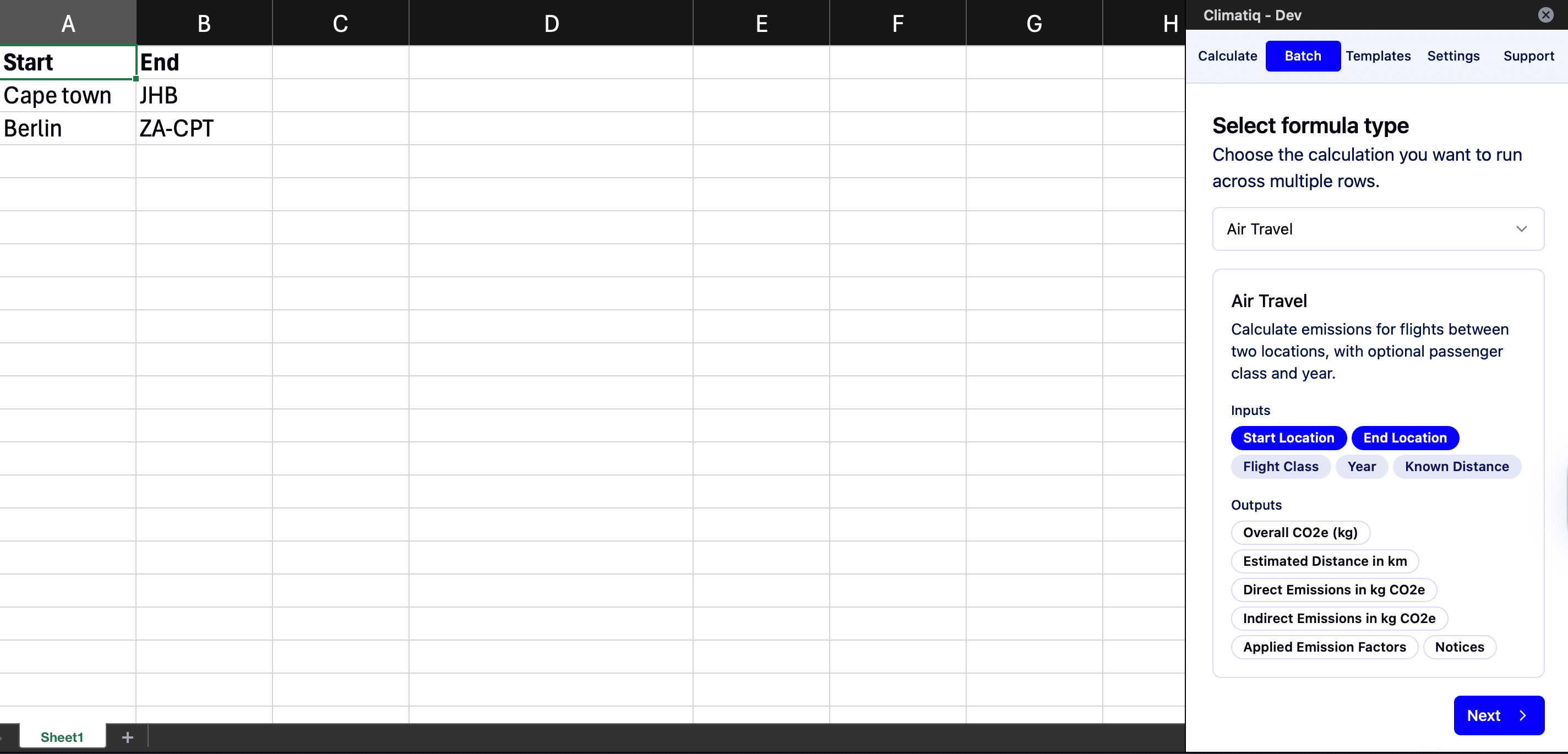

Open the Batch tab and choose the formula you want to run from the dropdown. A preview card appears showing the required inputs and the output columns that will be written to your sheet.

Configure inputs
For each input, you have two options:
- Range: point to a column in your sheet (e.g. A2:A500). You can type the address directly or click the crosshair icon to use your current Excel selection. Every row in the range becomes one API call.
- Fixed: type a single value that applies to every row (e.g. set Region to GB for all rows).
Required inputs are marked with a red asterisk. All range columns must be the same length; the batch will not run if they differ.

Configure output

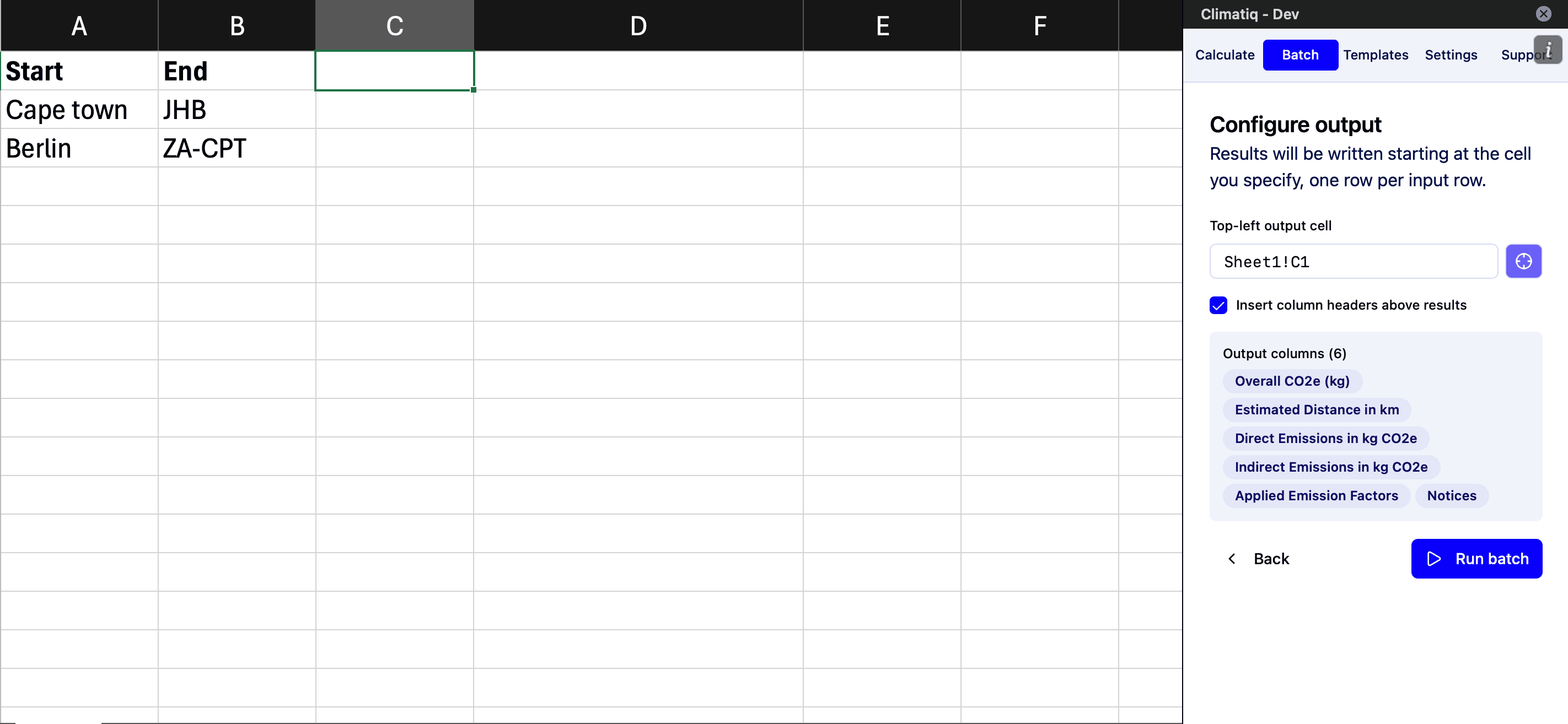

Enter the top-left cell where results should be written (e.g. D2), or click the crosshair to use your selection. Check Insert column headers above results to have Climatiq automatically write bold header labels in the row above your results.
Click Run batch to start.

Progress and results

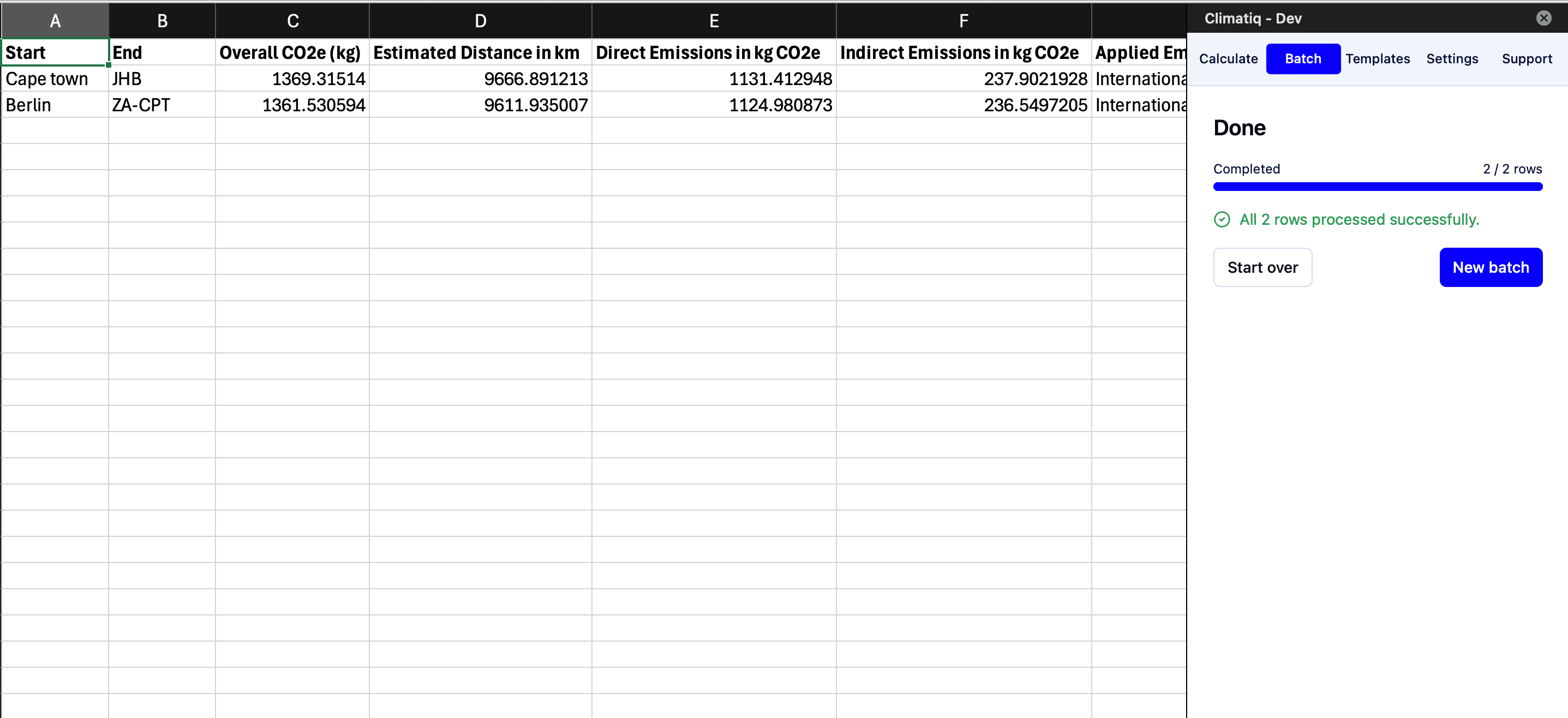

A progress bar shows how many rows have been processed. Results are written to your sheet in real time as each chunk completes. You do not need to wait for the whole batch to finish to see early rows.
- If individual rows fail (e.g. an unrecognized activity), they are written with an error message in the first output column and listed in a summary at the end. Successful rows are unaffected.
- If the batch encounters a fatal error (invalid API key, or insufficient access), it stops immediately and no rows are written.
- You can cancel at any time using the Cancel button. Rows already written are kept.
When complete, click New batch to start another run or Start over to change the formula type.

Tips
- Use Range mode for the activity description or ID column and Fixed mode for shared values like region, year, or source to avoid creating redundant columns in your sheet.
- Leave optional inputs on Fixed with an empty value to use the formula’s default behavior.
- For the Mapping Agent formula, enabling Fast Mode reduces accuracy slightly but processes rows significantly faster for large datasets.
Support and feedback
If you have questions, reach out to the Climatiq team via the website chat or our support form . If you’re finding the Add-In helpful, we’d appreciate a rating on Microsoft AppSource .
Formulas
The custom Climatiq formulas are split into four major categories:
- Estimations: Easily calculate the emissions for different kinds of business activities, e.g. travel, shipping and energy usage based on detailed methodologies.

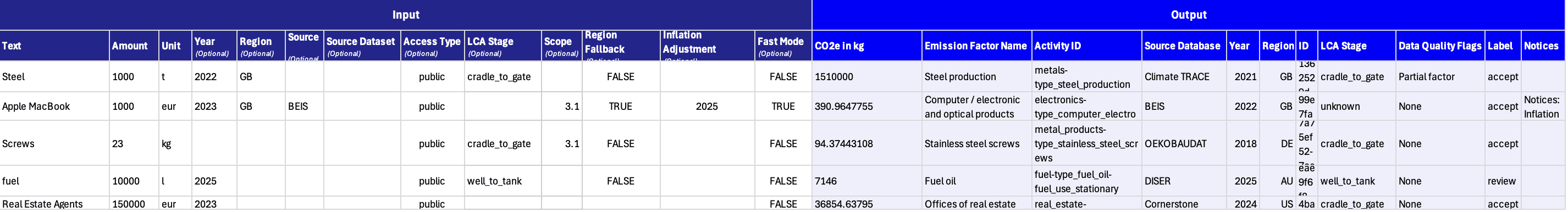

- Mapping Agent: Leverage Climatiq’s Mapping Agent to automate spend- and activity-based emission estimates.

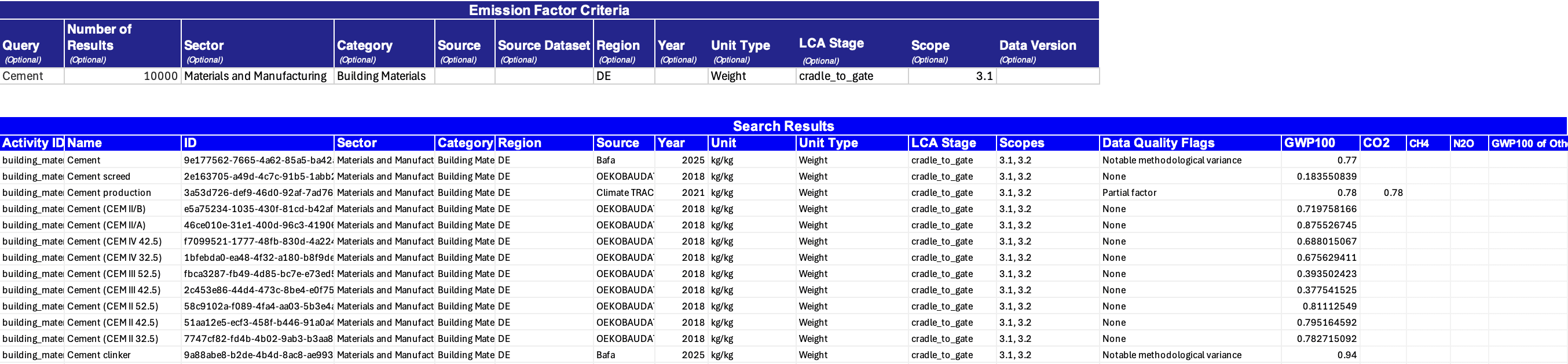

- Search: Look up emission factors from our Data Explorer, directly within Excel.
- Audit Trail: Add comprehensive audit-trail details to your emission estimate results.
Our YouTube Playlist provides step-by-step videos that guide you through every formula.
Freight shipping
Intermodal freight

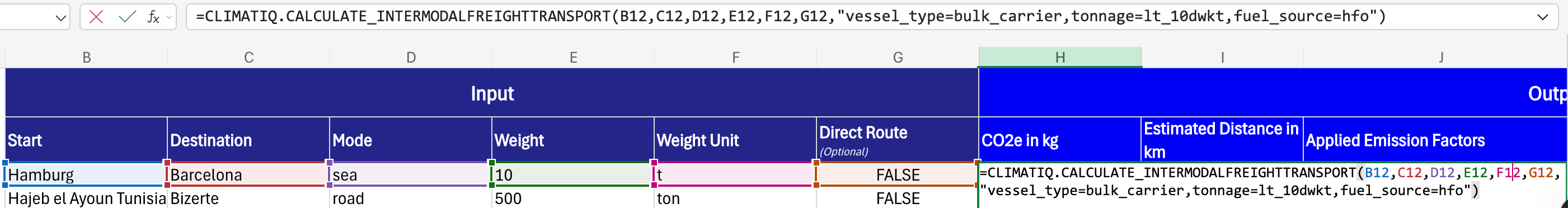

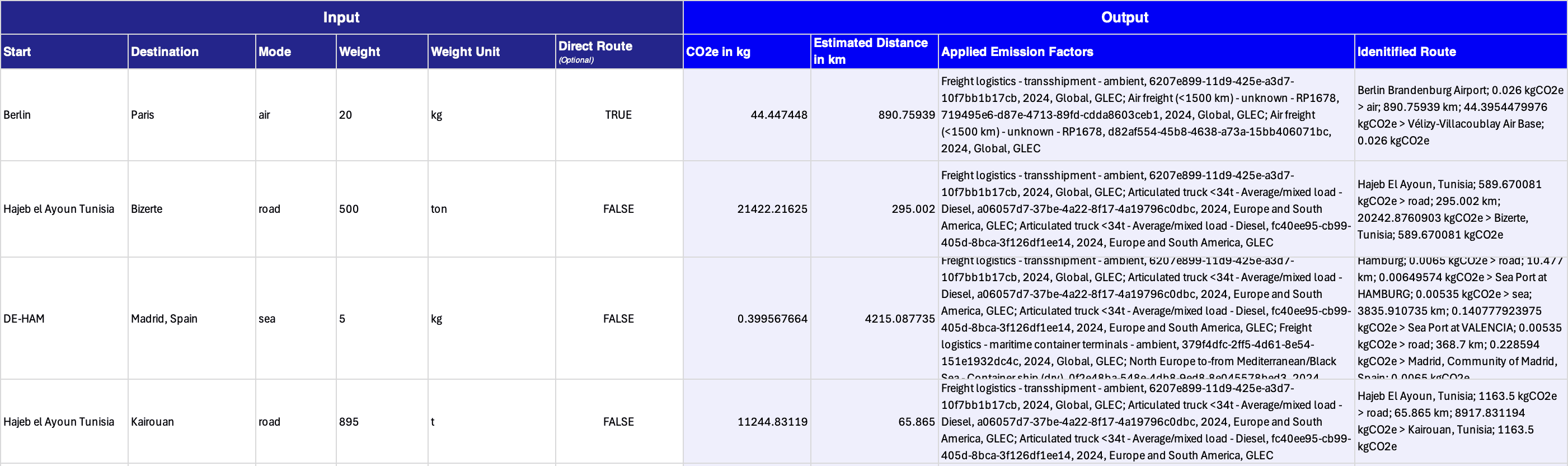

Calculate the total estimated emissions of freight shipping. The distance between the locations will be calculated by considering the actual transport network where possible.

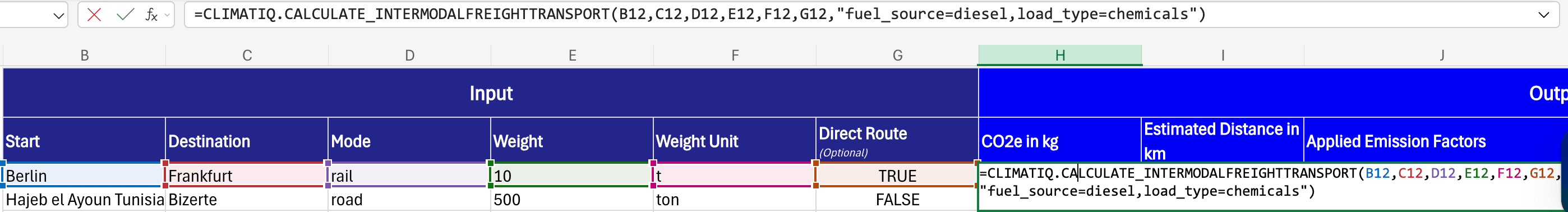

Climatiq.Calculate_IntermodalFreightTransport(start; end; mode; weight; weightUnit; direct; vehicle_details)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
start | ✓ | Text | Start location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
end | ✓ | Text | Destination location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
mode | ✓ | Text | Main mode of transport. Valid values are: air, road, rail and sea |
weight | ✓ | Number | Weight of the transported goods |
weight_unit | ✓ | Text | Unit of the weight. Valid values are: g, kg, t (metric ton), lb, ton (US short ton). |
direct | ✕ | True/False | Indicates if in case of sea, air or rail freight the road pre- and post-leg should NOT be added. |
vehicle_details | ✕ | Text | Allows you to input additional details on the vehicle used for the shipment. Refer to the examples below. |
Examples

Example inputs for vehicle_details
Add granularity to your Road, Rail, Air or Sea Freight calculations by including additional vehicle details. These need to be inputted in one vehicle_details input field, and not split out. Here are some examples of how to add these parameters into the Freight formula:
Road Freight
For road freight, it is possible to specify the vehicle_type, vehicle_weight and fuel_source. The table of valid parameter combinations is available here.
The following formula calculates emissions for a 10t road shipment from Berlin to Frankfurt using a diesel-powered van with a carrying capacity of ≤ 3.5t:

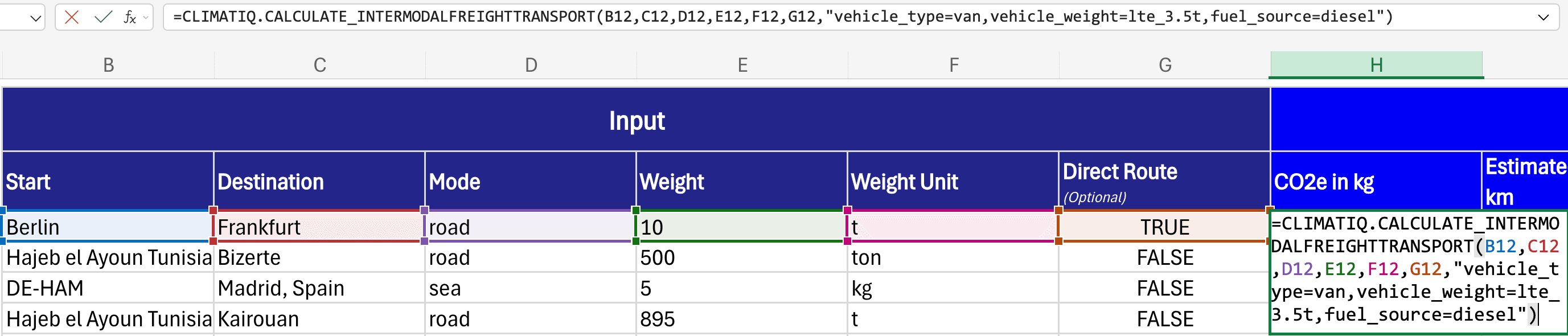

Climatiq.Calculate_IntermodalFreightTransport("Berlin","Frankfurt","road",10,"t",TRUE,"vehicle_type=van,vehicle_weight=lte_3.5t,fuel_source=diesel")

Sea Freight
For sea freight, it is possible to specify the vessel_type, tonnage and fuel_source. The table of valid parameter combinations is available here.
The following formula calculates emissions for a sea freight journey using a bulk carrier with a capacity of less than 10 deadweight kilotonnes (dwkt — the maximum tonnage that a ship can safely carry), powered by heavy fuel oil (hfo):
Climatiq.Calculate_IntermodalFreightTransport("Hamburg","Barcelona","sea",10,"t",FALSE,"vessel_type=bulk_carrier,tonnage=lt_10dwkt,fuel_source=hfo")

Air Freight
For air freight, it is possible to specify the aircraft_type of the vehicle, as well as the radiative_forcing_index. The table of valid parameter combinations is available here.
The following formula calculates emissions for a 10t air freight journey from Berlin to Cape Town in a freighter aircraft (dedicated cargo plane), with a radiative forcing index applied:

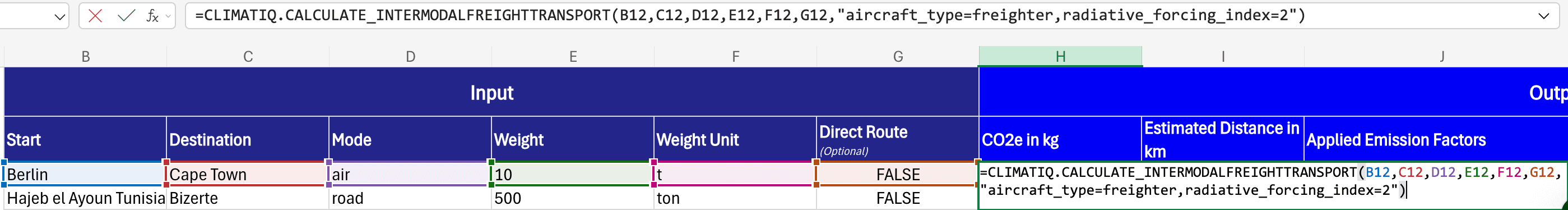

Climatiq.Calculate_IntermodalFreightTransport("Berlin","Cape Town","air",10,"t",FALSE,"aircraft_type=freighter,radiative_forcing_index=2")

Rail Freight
For rail freight, it is possible to specify the fuel_source of the vehicle, as well as the load_type. The table of valid parameter combinations is available here.
The following formula calculates emissions for a rail freight shipment for 10t of chemicals using a diesel-powered train:
Climatiq.Calculate_IntermodalFreightTransport("Berlin","Frankfurt","rail",10,"t",TRUE,"fuel_source=diesel,load_type=chemicals")

Travel
Air travel

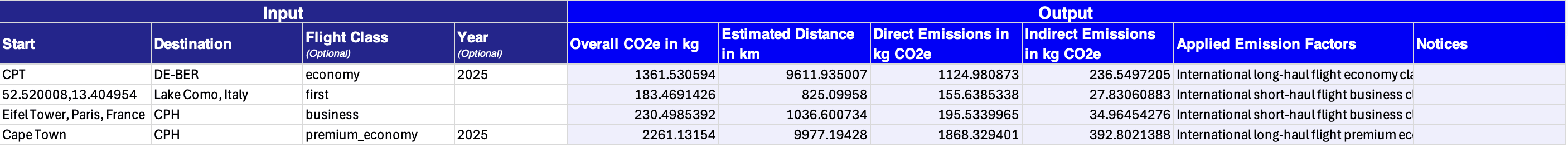

Calculate the total estimated emissions of air travel. The distance between the airports will be calculated using great circle distance.
Climatiq.Calculate_Travel_Air(start; end; flightclass; year; distance_km)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
start | ✓ | Text | Start location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
end | ✓ | Text | Destination location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
flightclass | ✕ | Text | Flight class, can be empty, average,economy, premium_economy, business or first. |
year | ✕ | Number | The year in which the travel occurred. |
distance_km | ✕ | Number | Known distance traveled in kilometers between start and destination. |
Examples

Road travel

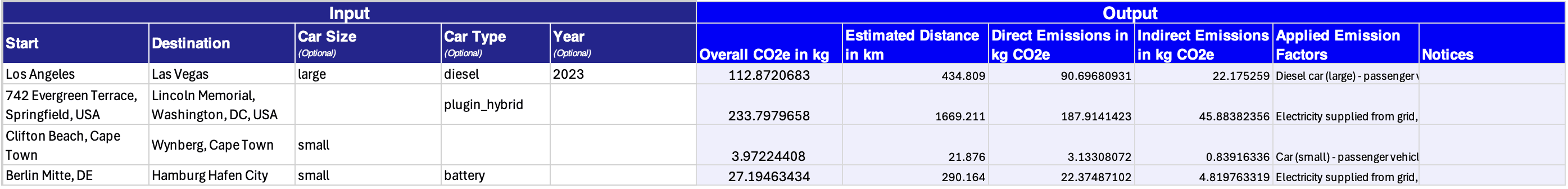

Calculate the total estimated emissions of road travel. The distance between the locations will be calculated by considering the actual road network where possible.
Climatiq.Calculate_Travel_Road(start; end; car_size; car_type; year; distance_km)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
start | ✓ | Text | Start location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
end | ✓ | Text | Destination location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
car_size | ✕ | Text | Size of the car. Valid values are small, medium, large and average. |
car_type | ✕ | Text | Type of fuel used by the car. Valid values are: petrol, diesel, hybrid (cars with a battery that is recharged by the internal combustion engine), plugin_hybrid (cars with an internal combustion engine and a battery that can be plugged in), battery (for electric vehicles) and average. |
year | ✕ | Number | The year in which the travel occurred. |
distance_km | ✕ | Number | Known distance traveled in kilometers between start and destination. |
Examples

Rail travel

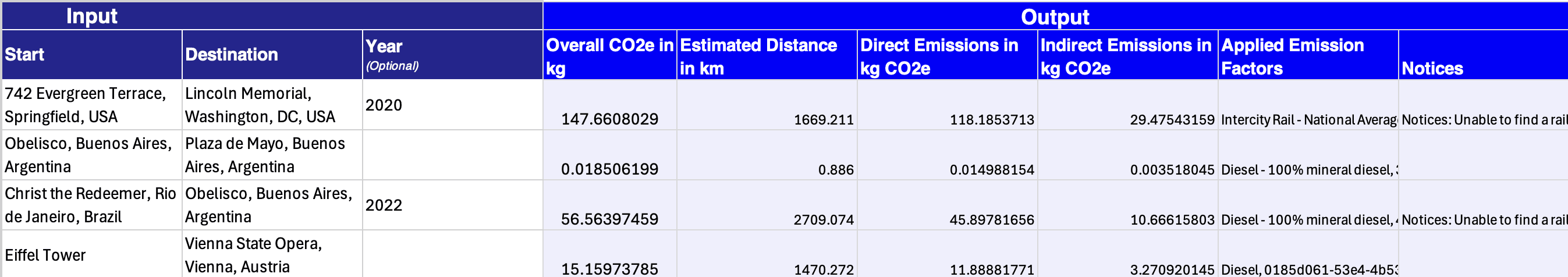

Calculate the total estimated emissions of rail travel. The distance between the locations will be calculated by considering the actual rail network where possible. Otherwise the road distance will be used.
Climatiq.Calculate_Travel_Rail(start; end; year; distance_km)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
start | ✓ | Text | Start location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
end | ✓ | Text | Destination location, can be free text (Berlin), IATA Code (BER), UN-LOCODE (DE-BER) or coordinates, i.e. lat & lon (52.520008,13.404954) |
year | ✕ | Number | The year in which the travel occurred. |
distance_km | ✕ | Number | Known distance traveled in kilometers between start and destination. |
Examples

Spend-based travel

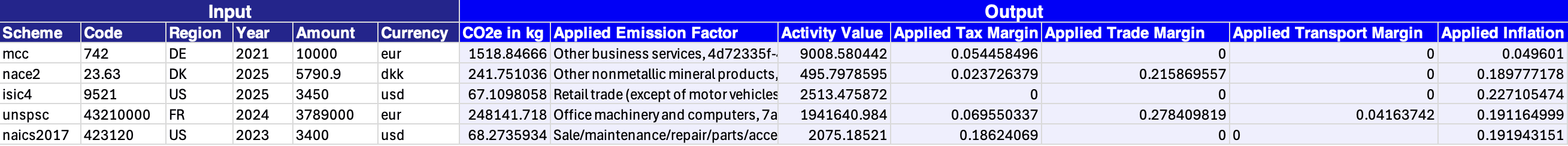

Calculate travel emissions based on spend-based data in any currency by using EXIOBASE emission factors. This calculation automatically takes inflation into account, if the year you spent the money was different than the year of the emission factor.

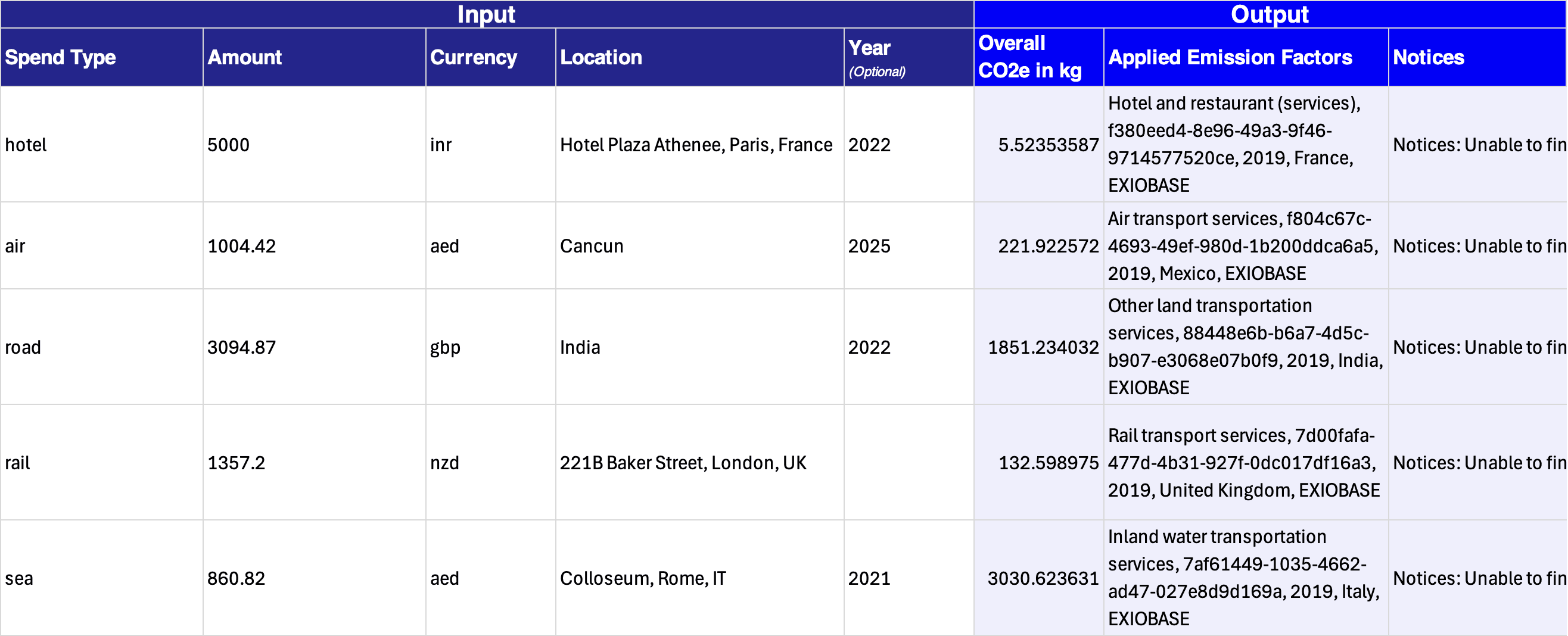

Climatiq.Calculate_Travel_Spend(spend_type; amount; currency; location; year)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
spend_type | ✓ | Text | The type of travel associated with the expenditure. Valid values are: air, road, rail, sea, and hotel. |
amount | ✓ | Number | The amount of money spent. |
currency | ✓ | Text | The currency in which the money unit is expressed. |
location | ✓ | Text | The location where money was spent, can be any type of free text. |
year | ✕ | Number | The year in which expenditures occurred. |
Examples

Energy
Electricity

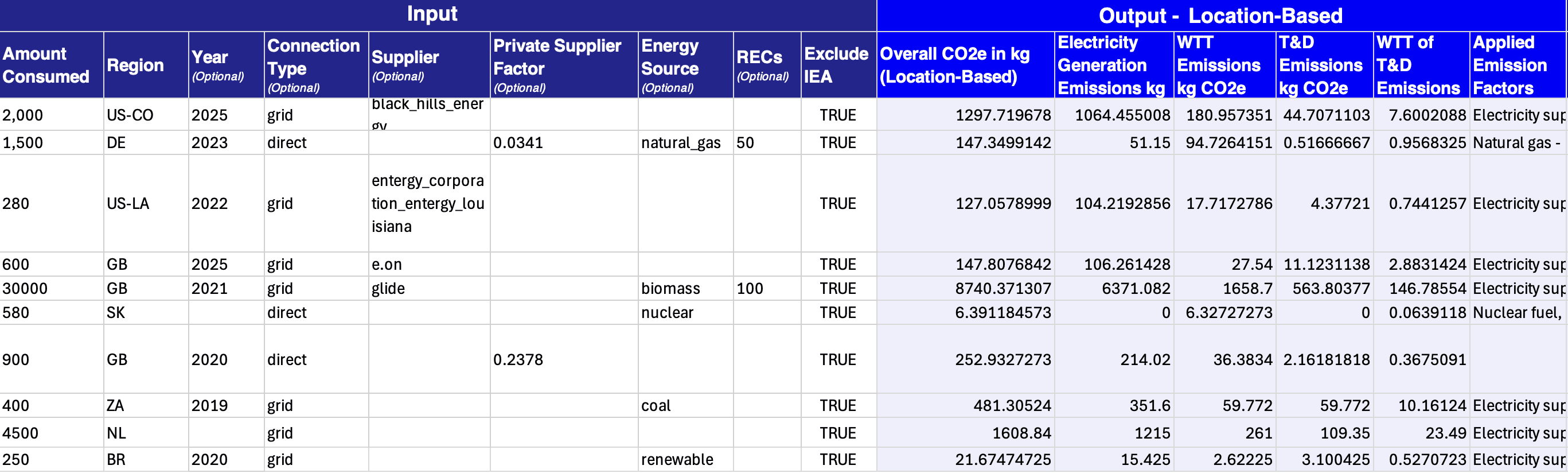

Estimate the emissions of electricity usage. The formula also provides details on the associated well-to-tank, transmission and distribution losses and their well-to-tank emissions.

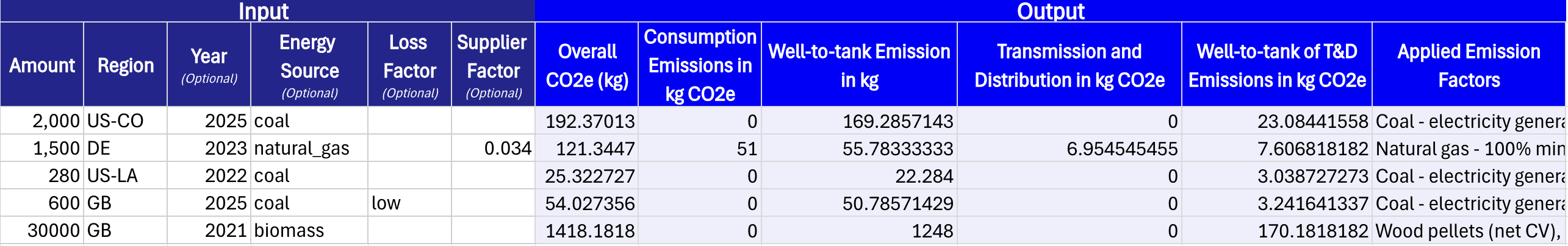

Climatiq.Calculate_Electricity(amount; region; year; connectionType; supplier; supplier_ef; energy_source; recs; excludeIEA)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
amount | ✓ | Number | Amount of electricity consumed in kWh. |
region | ✓ | Text | The country or region in which the electricity has been consumed. Must be the 2-digit UN code. |
year | ✕ | Text | Year of the electricity consumption |
connection_type | ✕ | Text | Either the electricity was delivered via the “grid” or via a direct line. Default is grid. |
supplier | ✕ | Text | Available where the region is GB or a US state, a supplier ID can be provided to use market factors for that supplier. Insert the “Energy” sheet from the Templates tab in the Add-In sidebar to view the accepted supplier codes. |
supplier_ef | ✕ | Number | Contracted emission factor for supplier, in kg CO2e/kWh. |
energy_source | ✕ | Text | The source that electricity is generated from. Valid values are renewable or specific fuel types such as natural_gas, coal, biomass and nuclear. |
recs | ✕ | Number | Quantity of RECs (Renewable Energy Certificates) in kWh to apply for market-based emission calculations. |
exclude_iea | ✕ | True/False | Indicates if emission factors from the IEA (a paid premium data source) should be excluded from the calculation. |
Examples

Fuel

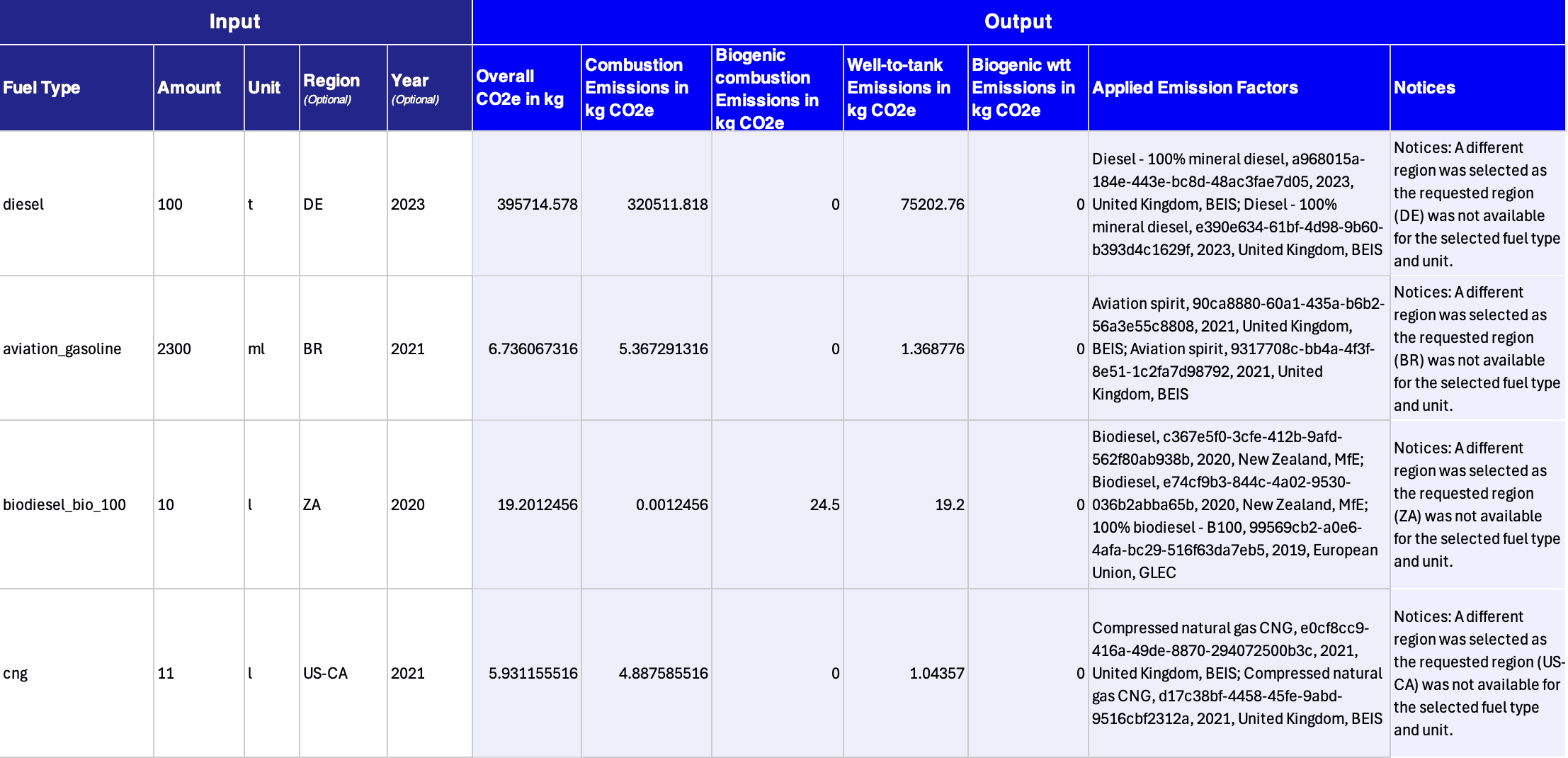

Estimate the emissions of fuel combustion. The calculation also provides details on the associated scope 3, i.e. the well-to-tank emissions.
Climatiq.Calculate_Fuel(fuel_type; amount; unit; region; year)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
fuel_type | ✓ | Text | Type of fuel burned, e.g. biodiesel, cng, fuelgas, etc. Insert the “Energy” sheet from the _Templates tab in the Add-In sidebar to view the accepted fuel types. |
amount | ✓ | Number | Amount of fuel burned. |
unit | ✓ | Text | Unit of provided amount, e.g. l, kg, kWh or others |
region | ✕ | Text | The country in which the fuel have been purchased. Must be the 2-digit UN code. |
year | ✕ | Number | Year of the fuel consumption |
Examples

Heat & steam
Estimate the emissions of heat and steam usage for combustion and well-to-tank.
Climatiq.Calculate_Heat_Steam(amount; region; year; energy_source; loss_factor; supplier_co2e)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
amount | ✓ | Number | Amount of heat used in kWh. |
region | ✓ | Text | Region of usage. Must be the 2-digit UN code. |
year | ✕ | Number | Year of usage. |
energy_source | ✕ | Text | The source that electricity is generated from. Valid values are renewable or specific fuel types such as natural_gas, coal, biomass and nuclear. |
loss_factor | ✕ | Text | The distribution loss factor for this component. Can be either “low”, “medium” or “high”. |
supplier_co2e | ✕ | Number | Contracted emission factor for the component, in kg CO2e/kWh. |
Examples

Mapping Agent
Mapping Agent (formerly known as Autopilot) is an AI-powered tool that automatically matches your business activity descriptions to the right emission factors, so you do not have to search for them manually. Trained on Climatiq’s verified emissions data and scientific methodology, it makes accurate carbon calculations accessible without requiring deep sustainability expertise.
It works with plain-language descriptions of your activities: invoice line items, spend categories, supplier names, or material descriptions. Mapping Agent finds the best-matching emission factor for each one and returns accurate, compliant emission estimates.
The Climatiq.Autopilot, Climatiq.Autopilot_Suggest, and Climatiq.Autopilot_EstimateSuggest
formulas have been renamed or removed. The Autopilot formulas remain functional until the end of
August 2026, but are deprecated and will display a deprecation notice in the Notices output
column.
To migrate, replace each formula with its equivalent:
- Replace
Climatiq.AutopilotwithClimatiq.MappingAgent - Replace
Climatiq.Autopilot_SuggestwithClimatiq.MappingAgent_Suggest - Replace
Climatiq.Autopilot_EstimateSuggestwithClimatiq.Calculate(General Estimate), using theactivity_idreturned byClimatiq.MappingAgent_Suggestinstead of thesuggestion_id, which has now been deprecated.
One-shot estimate
Calculate total estimated emissions produced for a particular activity, in kgCO2e, using free-text input. The best matching emission factor will automatically be selected and used for the calculation.
Climatiq.MappingAgent(text; amount; unit; year; region; source; source_dataset; access_type; lca_stage; scope; region_fallback; apply_inflation_adjustment; fast_mode)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
text | ✓ | Text | The free-form input text, such as an activity name, service or material name. |
amount | ✓ | Number | Amount for which the emissions shall be calculated. |
unit | ✓ | Text | Specific unit of the consumed amount, e.g. usd for Money, l for Volume or kg for Weight. Insert the Units Guide from the Templates library in the Add-In sidebar for guidance. |
year | ✕ | Number | Year in which the activity took place. |
region | ✕ | Text | A region code describing the geographic region to which the emission factor should apply. |
source | ✕ | Text | The source(s) to be searched in. If you search in multiple sources, split them with a comma, e.g. “BEIS,EPA,Ecoinvent”. |
source_dataset | ✕ | Text | The source dataset(s) to be searched in. If you search in multiple sets, split them with a comma. |
access_type | ✕ | Text | Filters by the access type of the emission factors. Accepted inputs are public, private and premium. |
lca_stage | ✕ | Text | Filters by a specific Lifecycle Activity Stage. Possible lca_stage options are outlined in the LCA Guide. |
scope | ✕ | Text | Filters by scope, such as 1, 2, 3.1,3.2, etc. Scope 3 categories can be explicitly stated (such as 3.1) or all Scope 3 categories can be selected by specifying 3. Multiple scopes can be split with a comma. Read more about scopes here. |
region_fallback | ✕ | True/False | Set this to true if you’re willing to accept a less specific geographical region than the one you’ve specified. |
apply_inflation_adjustment | ✕ | Number | The spend year for inflation adjustment (e.g. 2023). Pass 0 or omit to skip inflation adjustment. Use this when the emission factor has a money-based unit. |
fast_mode | ✕ | True/False | Set to true for faster but less accurate matching. Default is false (high accuracy). |
Examples

Suggest
Receive a number of suggested emission factors for a particular input query. You can adjust the number of suggestions to return. Suggestions are ordered by the most likely match first.
Each result includes full emission factor details and an activity_id. To calculate emissions for a selected match, pass that activity_id to the General Estimate formula (Climatiq.Calculate).
Climatiq.MappingAgent_Suggest(results; text; unit_type; year; region; source; source_dataset; access_type; lca_stage; scope; region_fallback; flatten; fast_mode)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
results | ✓ | Number | The maximum number of suggestions to receive. Mapping Agent will return as many suitable suggestions as it can find, up to the max number requested, or at most 20 suggestions. |
text | ✓ | Text | The free-form input text, such as an activity name, service or material name. |
unit_type | ✕ | Text | The unit types of the activity, can be Weight, Money, Volume and Number. When searching across multiple types, split them with a comma, e.g. “Money,Volume” |
year | ✕ | Number | Year in which the activity took place. |
region | ✕ | Text | A region code describing the geographic region to which the emission factor should apply. |
source | ✕ | Text | The source(s) in which should be searched in. If you search in multiple sources, split them with a comma, e.g. “BEIS,EPA,Ecoinvent” |
source_dataset | ✕ | Text | The source dataset(s) to be searched in. If you search in multiple sets, split them with a comma. |
access_type | ✕ | Text | Filters by the access type of the emission factors. Accepted inputs are public, private and premium. |
lca_stage | ✕ | Text | Filters by a specific Lifecycle Activity Stage. Possible lca_stage options are outlined in the LCA Guide. |
scope | ✕ | Text | Filters by scope, such as 1, 2, 3.1,3.2, etc. Scope 3 categories can be explicitly stated (such as 3.1) or all Scope 3 categories can be selected by specifying 3. Multiple scopes can be split with a comma. Read more about scopes here. |
region_fallback | ✕ | True/False | Indicates if Mapping Agent should search in other regions, if no factor can be found for the given region. |
flatten | ✕ | True/False | Indicates if the calculation details of the matches should also be shared, i.e. estimated emissions and the details of the used emission factor (name, source, Climatiq UUID) |
fast_mode | ✕ | True/False | Set to true for faster but less accurate matching. Default is false (high accuracy). |

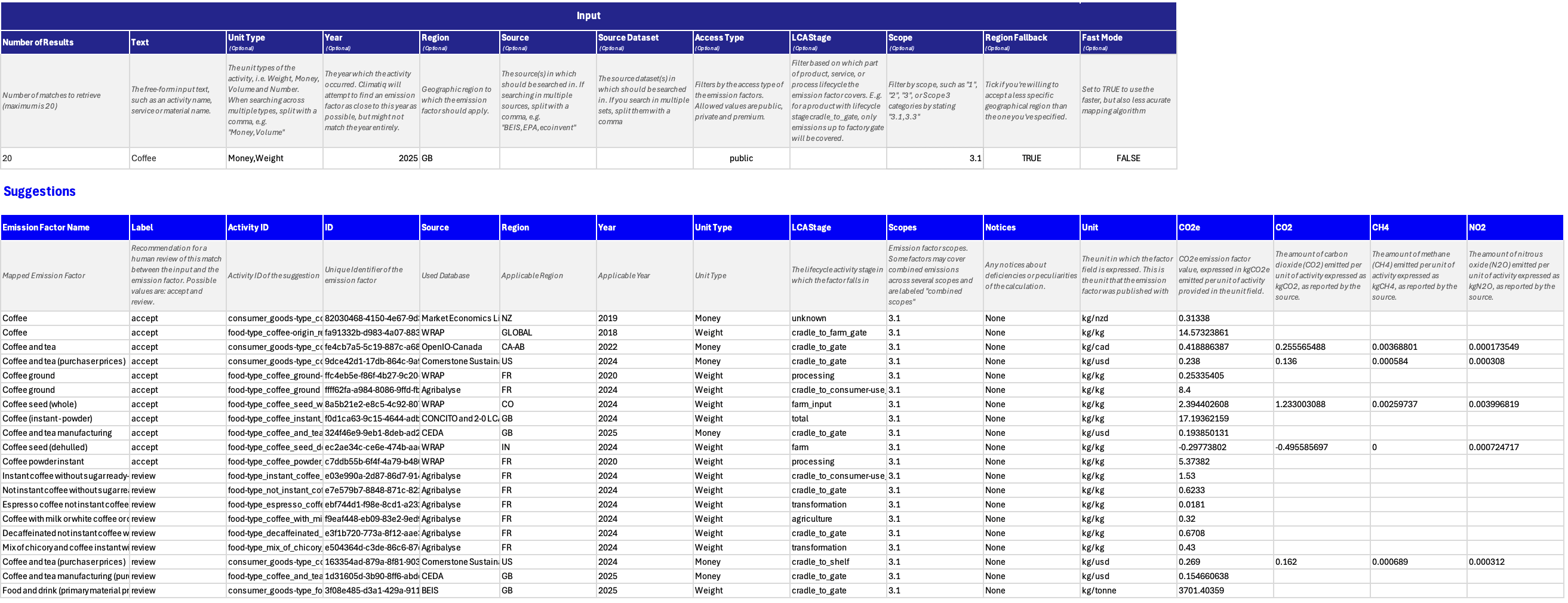

Example - Not Flattened

Using Suggest results with General Estimate
Climatiq.MappingAgent_Suggest returns full emission factor details for each match, including an activity_id and an emission factor id. To calculate emissions for a selected match, pass either the activity_id or the emission factor id to the General Estimate formula (Climatiq.Calculate). Using the emission factor id pins the calculation to that exact factor; using the activity_id allows Climatiq to resolve the best available factor at calculation time.

Procurement
By industry classification code
Estimate the emissions for a purchase using an industry classification code to identify the type of purchased goods or service. This calculation accounts for tax, trade and transport margins using per-sector and per-country margins from EXIOBASE, if no user-supplied margins are provided. It also corrects for currency exchange rates and inflation adjustments, using rates from the UN Treasury, supplemented with per-industry inflation numbers from Eurostat. You can find details on the methodology here.
Climatiq.Calculate_Procurement_ByClassification(scheme; code; region; year; amount; currency)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
scheme | ✓ | Text | The classification scheme used. Valid values are: mcc, nace2, unspsc, isic4 and naics2017. |
code | ✓ | Number | Specific code of the classification. Please be aware that UNSPSC is only available up to a family level, i.e. the last four digits should be 0. Find more on classification codes here. |
region | ✓ | Text | The country in which the goods have been purchased, i.e. ideally the supplier country. Must be a 2-digit country code from ISO-3166-1 . Insert the “Regions” guide from the Templates library in the Add-In sidebar to view all available region UN codes. |
year | ✓ | Number | Year of purchase |
amount | ✓ | Number | Spend amount |
currency | ✓ | Text | Currency of the spend. Insert the “Currency” guide from the Templates library in the Add-In sidebar to view all available currencies. |

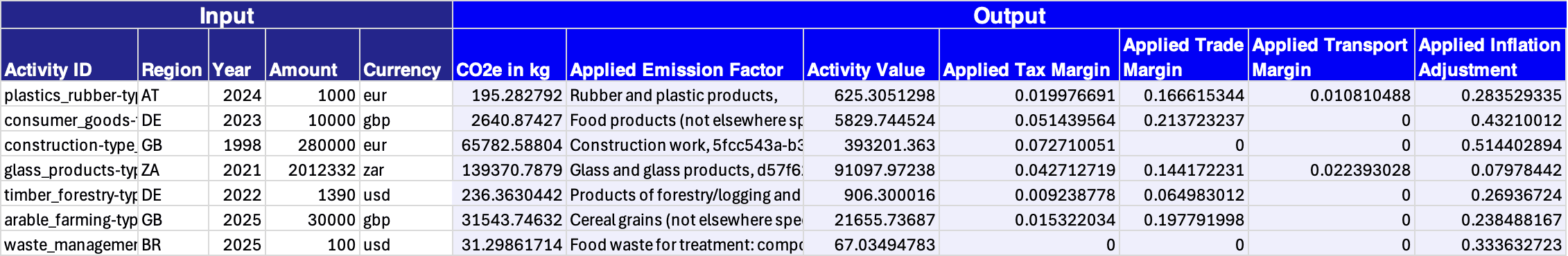

Examples

By Climatiq activity ID
Estimate the emissions for a purchase using a Climatiq activity ID to identify the type of purchased goods or service. This calculation automatically accounts for tax, trade and transport margins using per-sector and per-country margins from EXIOBASE. It also corrects for currency exchange rates and inflation adjustments, using rates from the UN Treasury, supplemented with per-industry inflation numbers from Eurostat. You can find details on the methodology here.
Climatiq.Calculate_Procurement_ByActivityID(activity_id; region; year; amount; currency)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
activity_id | ✓ | Text | An ID describing the activity, specifically related to an EXIOBASE 3.8 factor. Multiple emission factors can share the same activity_id, e.g. if they are from a different source or apply to a different region. You can search for activity_ids in the Data Explorer or via the search formulas. |
region | ✓ | Text | The country in which the goods have been purchased, i.e. ideally the supplier country. Must be a 2-digit country code from ISO-3166-1 . Insert the “Regions” guide from the Templates library in the Add-In sidebar to view all available region UN codes. |
year | ✓ | Number | Year of purchase |
amount | ✓ | Number | Spend amount |
currency | ✓ | Text | Currency of spend. Insert the “Currency” guide from the Templates library in the Add-In sidebar to view all available currency codes. |
Examples

Other
Search emission factors
Search the emission factor database of Climatiq. Please be aware that this might only return a subset of results (depending on the number of results specified). The search works in the same way as our Data Explorer . The formula returns a table of results, so make sure the surrounding cells are empty when using this formula.
Depending on whether an existing Climatiq subscription to use the raw emission factors is in place, these will also be returned as part of the response. If you want to gain access to the raw emission factors, please reach out to our team .
Climatiq.Search_EmissionFactors(query; numberOfResults; sector; category; source; source_dataset; region; year; unit_type; lca_stage; scope; data_version)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
query | ✕ | Text | A free-text query that will match ids, names, descriptions, etc. of emission factors. This uses fuzzy matching, so your query does not need to be precise. |
number_of_results | ✓ | Number | The number of results to be shared. The maximum value is 10,000. |
sector | ✕ | Text | Filters by emission factor sector. Refer to the Data Explorer for a list of available options. |
category | ✕ | Text | Filters by emission factor category. Refer to the Data Explorer for a list of available options. |
source | ✕ | Text | Filters by emission factor source. Refer to the Data Explorer for a list of available options. |
source_dataset | ✕ | Text | The source dataset(s) to be searched in. If you search in multiple sets, split them with a comma. |
region | ✕ | Text | Filters by emission factor region. Refer to the Data Explorer for a list of available options. |
year | ✕ | Number | Filters by applicable year. |
unit_type | ✕ | Text | Filters by emission factor unit type, e.g. Money or Volume. Refer to the Data Explorer for a list of available options. |
lca_stage | ✕ | Text | Filters by Life Cycle Assessment stage, e.g. well-to-tank. Refer to the Data Explorer for a list of available options. |
scope | ✕ | Text | Filters by scope, such as 1, 2, 3.1,3.2, etc. Scope 3 categories can be explicitly stated (such as 3.1) or all Scope 3 categories can be selected by specifying 3. Multiple scopes can be split with a comma. Read more about scopes here. |
data_version | ✕ | Text | Filters for a specific version of the Climatiq database. i.e, 27. Read our Data Version Changelog to stay up to date with our current versions. |
Examples

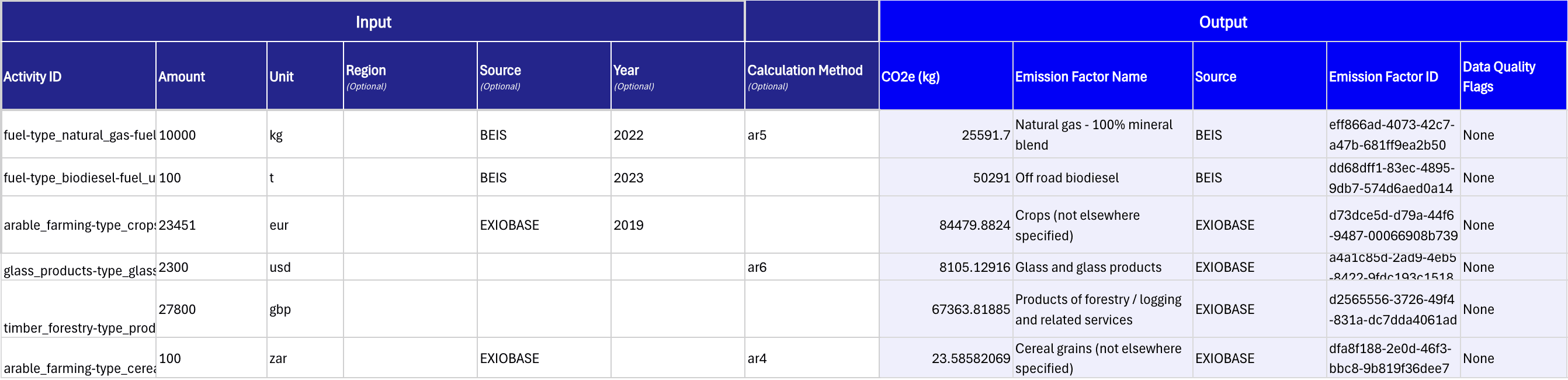

General estimate
Calculate the total estimated emissions produced for a particular activity, in kgCO2e, using any emission factor in the Climatiq database.
Climatiq.Calculate(activityID; amount; unit; region; source; year; calculation_method; apply_inflation_adjustment)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
activity_id | ✓ | Text | An ID describing the activity that to search for. Multiple emission factors can share the same activity_id, e.g. if they are from a different source or apply to a different region. You can search for activity_ids in the Data Explorer or via the search formulas. |
amount | ✓ | Number | Amount for which the emissions shall be calculated. |
unit | ✓ | Text | Specific unit of the consumed amount, e.g. usd for Money, l for Volume or kg for Weight. See the full list here. |
region | ✕ | Text | A region code describing the geographic region to which the emission factor applies. |
source | ✕ | Text | Desired emission factor source. |
year | ✕ | Number | Year in which the activity took place. |
calculation_method | ✕ | Text | The calculation method that will be used to calculate the CO2e emission factor. Valid inputs are ar4, ar5 or ar6. |
apply_inflation_adjustment | ✕ | Number | The spend year for inflation adjustment (e.g. 2023). Pass 0 or omit to skip inflation adjustment. Use this when the emission factor has a money-based unit. |
Examples

Audit Trails
Search by ID
For further auditing, you can use the Search by ID formula to retrieve detailed information about a specific emission factor used in Climatiq calculations.
Climatiq.Search_ByID(ID)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
id | ✓ | Text | A unique ID which points to one particular emission factor. |
The formula requires the ID, not the activity_id. For example, the emission factor for Office machinery and computers has:
activity_id: office_equipment-type_office_machinery_computersID: 1afd8f9f-6cd9-485d-9801-4d5f3e5286b2
By entering the emission factor’s ID into the formula, you’ll receive additional details including:
- The raw factor value, if you have access to it
- Year released
- LCA activity stage
- Calculation method
- Constituent gases (where applicable)
- Source dataset
- URL to the specified emission factor in our Data Explorer
This provides auditors and reviewers with a straightforward link to our vetted emission factor database for transparent verification.
To label the output data with column headers, insert the Climatiq.Search_ById_Headers() formula within Excel.
Examples

Retrieve factor details

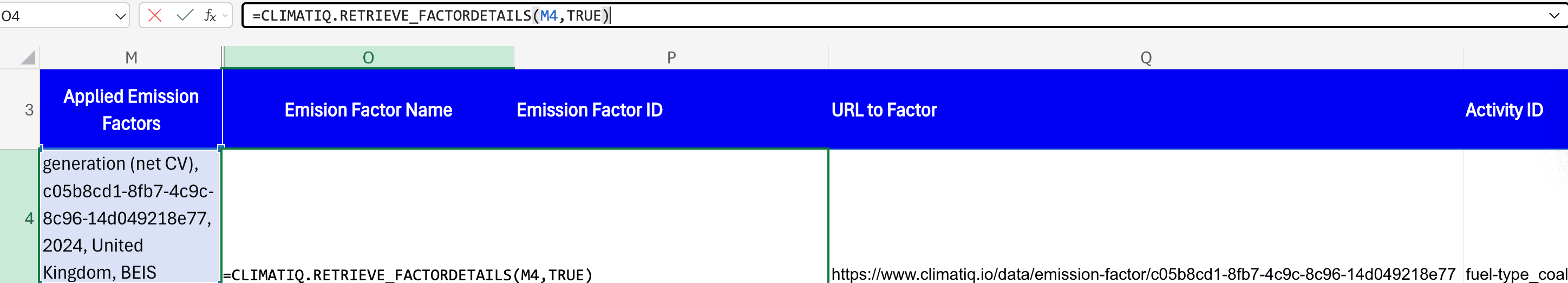

For further auditing, you can apply the Retrieve Factor Details formula to retrieve detailed factor information for multiple emission factors used in Climatiq calculations. If the original Climatiq calculation returned an “Applied Emission Factors” column with multiple factors, use the Retrieve Factor Details audit formula instead of the Search by ID formula.
Climatiq.Retrieve_FactorDetails(factors; flattened)
Parameters
| Name | Required | Type | Description |
|---|---|---|---|
factors | ✓ | Text | A reference to the cell which hold the emission factor details, titled as “Applied Emission Factors”. |
flatten | ✕ | True/False | Whether the results should be returned in a matrix table or a flattened series of cells. |

Frequently asked questions
General
Which Excel versions support the use of the Add-In?
The Add-In is available for Excel on Windows (Excel 2013 and later), Excel on Mac (Excel 2016 and later) and Microsoft 365 Online. Installing it once for your Microsoft account via the Microsoft AppSource will make the Add-In available to you across all platforms.
Is the Climatiq Excel add-in free to use?
If you are signed up to our Community Plan, our Excel add-in is free for non-commercial use, supporting up to 250 calculations per month. If you require higher calculation volumes or commercial use, please contact our sales team to discuss your needs or watch a demo recording .
How do I use the Climatiq formulas to calculate emissions?
Access to all our formulas use the =CLIMATIQ format. When typing this into a cell in sheets, a variety of different formulas will appear. Alternatively, in the Calculate tab of the Add-In, there is an “Insert Formula” button. These formulas can be applied in your existing Excel workbooks of business data.
What emission factors are available in the Excel add-in?
By default, you can access emission factors from all sources except for ecoinvent , IEA and EXIOBASE v3.10 data. These premium sources require an additional subscription to be in place and are available via the estimation and Mapping Agent formulas with a valid subscription with Climatiq in place.
Can we manage or revoke keys centrally?
Yes, you can manage your keys via the Climatiq dashboard and create new keys for any occasion. We also recommend to make use of Climatiq’s project management. This allows you to create a new project in your Climatiq dashboard for each new engagement. Each key belongs to a project - this allows you to create separate keys for different use cases or scenarios - and a project can hold several keys. You can track the number of calculations made per project in the Climatiq Dashboard, and enable or disable keys associated to this project as needed.
How does performance scale if we have thousands (or tens of thousands) of rows?
The Add-In can handle up to 100 complex calculations being performed in parallel e.g. for shipment, travel, or Mapping Agent requests. Making parallel requests exceeding this volume within a short time frame may result in errors in Excel. We therefore recommend to perform calculations in batches, i.e. insert the formula into 100 cells, wait a few seconds for the calculations to be completed and continue with the next set of 100 calculations. If you are aiming to perform calculations for tens of thousands of data points at once on a large scale, we recommend reaching out to our team to explore data processing options via the Climatiq API directly.
How can I get a direct link to the emission factors used in my calculations?
In a new Excel cell, enter this formula to create a clickable link:
="https://www.climatiq.io/data/emission-factor/" & [ID_CELL]Replace [ID_CELL] with the cell reference containing the emission factor ID from your results. Alternatively, our Search by ID and Retrieve Factor Details audit trail formulas also provide these URLs automatically.
Can I use combined units when making carbon estimates (e.g. tonne-kilometers)?
Yes. For emission factors that use a combined unit such as weight-over-distance, concatenate the weight and distance units as a single string (e.g. t_km, kg_km, mile_lb) and provide weight × distance as the amount. For example, 2 tonnes transported over 10 km would be entered as amount 20 with unit t_km.
Troubleshooting
Why am I getting an “Climatiq key not set” error in fields?
Your Climatiq key may not be set, was set incorrectly or Excel is not recalculating the formula. To fix this issue, ensure the Climatiq Add-In is installed and that your key is set in the “Overview” page, or that you have set the key for the current file in the Settings tab of the Add-In. After setting the key, you can re-calculate the fields in which this error is shown.
Why am I getting a “#NAME!” error in my formulas?
This error is shown by Excel if it is trying to resolve the name of a formula or variable, but it not able to do so, because the name is unknown to Excel. One common cause are missing quotation marks (””) around alphabetical inputs. To fix this, make sure to wrap any text values, like city names, unit types, transportation modes and others in quotation marks (e.g., use “Berlin” instead of Berlin).
Another cause for this that Excel is not able to install the Add-In properly and is therefore unable to resolve the Climatiq formulas. In this case there should also be an error message shown in the footer bar of Excel. You can try to reinstall the add-in if custom formulas are not recognized. You can reinstall the Add-In by first navigating to the Add-in management view (Main Menu Bar - “Add-Ins” - “More Add-Ins” - “My Add-Ins”) and deleting the Add-In. You can then re-install it via the same view. If these fixes do not work, your company policies might block external Add-Ins from loading.
What does the “You do not have access to this feature” message mean?
You have already exceeded your monthly limit of 250 free calculations, or you are trying to access a calculation feature that is not part of your current subscription plan with Climatiq. Get in touch with our sales team to start a free trial based on your needs, or to learn more about our paid plans to upgrade for more access.
Why isn’t the Climatiq add-in showing up in Excel after adding it via the Microsoft AppSource?
The add-in may not be installed correctly. If the Climatiq Logo is appearing on your Excel navigation bar, but none of the formulas are working, you can try to reinstall the add-in. You can reinstall the Add-In by navigating to the Add-in management view (Main Menu Bar - “Add-Ins” - “More Add-Ins” - “My Add-Ins”) and first deleting it. Afterwards you can re-install it via the search bar in the same view. If the logo is not appearing in the navigation bar, open Excel > Click the red “Add-ins” button on the top right and search for “Climatiq” to install it.
How do I share an Excel sheet with Climatiq formulas?
If the recipient does not have the Climatiq Add-In installed, the Climatiq formulas will not be properly calculated in their Excel environments. Therefore, you will want to make sure to replace any cells using Climatiq formulas with the calculated values by copying the formula results and pasting them as values (Paste Special > Values).
Why am I getting an “Error loading add-ins” or “Error installing formulas” message?
These errors are usually caused by internal company firewalls blocking the required resources to be loaded.
First try clicking the Climatiq Add-In in the Excel ribbon to manually initialize it. Alternatively, you can try to reinstall the Add-In. You can reinstall the Add-In by navigating to the Add-In management view (Main Menu Bar - “Add-Ins” - “More Add-Ins” - “My Add-Ins”) and first deleting it. Afterwards you can re-install it via the search bar in the same view.
If these fixes do not work, your company policies might be blocking external Add-Ins from loading. Ask your IT team to allow access to https://excel.climatiq.io (via port 443) and ensure network settings do not block JSON file requests.
Security
How are updates to the Add-In being handled?
Whenever an update to the Add-In is being published, Excel will automatically install the latest version for you. Microsoft Excel does currently not support an opt-out for new versions of Add-Ins. To stay up-to-date with new releases and improvements of the Add-Ins, you can check out our Changelog and subscribe to our monthly Release Notes .
Does Climatiq have specific certifications (ISO, SOC 2, GDPR) that cover data processed via the Excel add-in?
Climatiq’s compliance with ISO 27001, SOC2 and GDPR is externally certified - you can find further details in our Trust Center .
How exactly is data routed from Excel to the Climatiq platform and back?
The diagram below shows a high-level overview of the dataflows between Excel and the Climatiq API. For more details, please reach out to us.

What are the types of data that are stored by Climatiq when using the Add-In?
Climatiq does not store the transacted business data that is part of the request. The only exception here is the search query of Mapping Agent requests. This data point will be fully anonymized, aggregated and potentially used as training data to further improve the accuracy of Mapping Agent. As the data is stripped of any user context before being used for training, no tracebacks to the original source of the data point can be made.
Additionally, other types of data are retained, all stored on servers within the European Union:
- Project Data: Configuration data, project name, API keys
- User PII: Account data like email and name and surname are stored after the sign-up
- Client IP Addresses: Belonging to end users, programs or servers that perform requests to the Climatiq API or use our Dashboard.
- API Request Metadata: Request metadata generated during an API call is stored as logs
All data access is strictly controlled and audited as part of Climatiq’s ISO27001 certification. Data is deleted upon request or 60 days after contract termination.
